Project Monitoring

Project Sampling


Runoff samples were collected from 18 collection sites during artificial storms generated by a water truck applying 12,000 gallons of water on the site (1,000 gallons per test segment) over the course of about 7 passes.

This amount was chosen due to practical constraints which included applying enough water to provide for flow into the collection vaults without applying too much water that would flush all the pollutants off within the first couple of passes by the water truck.

This amount of water is equivalent to an 17-hour volume of a 10-year, 24-hour storm intensity. This is also equivalent to 12 hours of a 24-hour, 100-year storm intensity.

Sample Analysis


Samples will be analyzed by the City of Yakima Wastewater Treatment Laboratory for stormwater pollutants associated with urban locations including:
  • Total suspended solids (TSS)
  • Biological oxygen demand (BOD)
  • Total petroleum hydrocarbons (TPH)
  • Fecal coliform (FC)
  • Copper (Cu)
  • Lead (Pb)
  • Zinc (Zn)

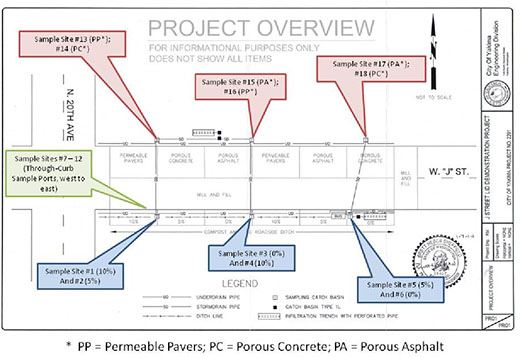

Project Overview

Construction Sampling Tests

Tanker truck dumping water on test site.

Tanker truck 2

Result of water on porous concrete and permeable pavers immediately after receiving water.

Permeable Pavers wet

Tanker truck dumping water. Samplers are standing by.

Tanker truck

Sampling vault after the test.

Sampling Vault
